Overview

The Skype to Teams Migration Initiative is a year-long project to update and modernize the University’s communications systems by migrating the underlying software of the University’s telephone system from Skype for Business to Microsoft Teams. Currently, MSU Denver phone numbers – whether assigned to individual employees or department lines – run on Skype for Business, either using the app or through a Polycom phone. Once this project is complete, all phone call functionality across the institution will instead run through the Microsoft Teams app. This project will also incorporate mandatory E911 call settings for emergency response.

The changes in this project are impactful to the whole University, and ITS is committed to making a smooth transition for all faculty, staff, and students.

Latest News

Last update: February 2026

Current Phase: Complete!

The project team has finished migrating over all users and departments from Skype for Business to Microsoft Teams. The University in whole was migrated in eight phases over the course of 2025, with a total of 2091 phone numbers migrated. The final step – replacing common area phones with Teams-compatible phones – was completed in November 2025.

Thank You!

The project team would like to thank the University community for all the support and feedback you’ve provided to help make this transition as smooth as possible. We would also like to thank all the ITS team members that helped with this initiative!

Getting Support

Now that the University is wholly migrated to Teams, ITS telephony support is dedicated to the new platform. Several articles on how to use Teams for telephony are available in the ITS Knowledgebase. If you need further assistance, please submit a support request through the ITS Service Catalog or contact the ITS Service Desk.

Timeline

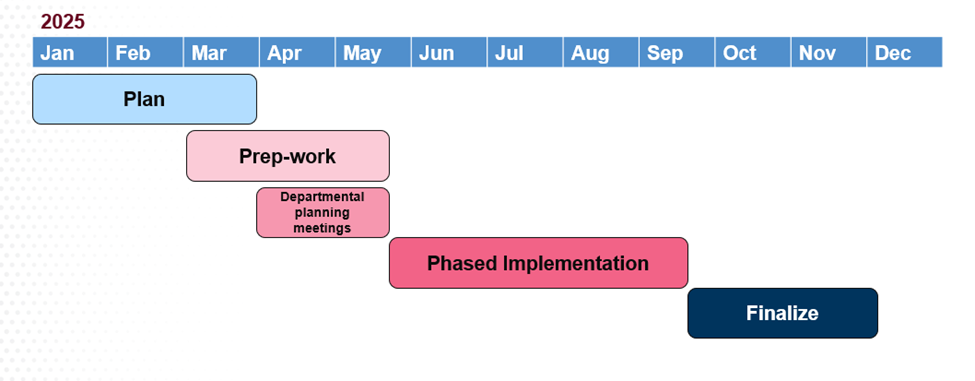

Timeline of Skype to Teams migration plan for 2025

Migration Timeline:

To minimize risk and facilitate the work being done, migrations will be performed in phases organized by building and/or location. Each phase will cover all departments within those locations. Please note current scheduling is only approximate, but exact dates will be shared as implementation plans are finalized.



Phase Buildings Dates
Phase 1 Administration
800 Kalamath
Quigg Newton Center
July 8th
Phase 2 Aerospace and Engineering Sciences (AES)
Hospitality Learning Center (HLC)
Regency Athletic Complex (RAC)
July 15th
Phase 3 7th Street
9th Street Park
Arts Building
King Center
Medical Center of Aurora North Campus
965 Santa Fe Drive
July 22nd
Phase 4 PE Event Center
Plaza Building
Science Building
Bear Creek (BRC)
Rectory Office
July 29th
Phase 5 West Classroom
Tivoli Student Union
September
Phase 6 Central Classroom September
Phase 7 Jordan Student Success Building – Group A September
Phase 8 Jordan Student Success Building – Group B September
